partially open structure-engineering express

Partially Enclosed Structures Explained

Understanding whether a building is partially enclosed is a critical step in wind design. This classification determines the internal pressure coefficients (GCpi) used in ASCE 7 and directly affects the loads applied to components such as windows, doors, roofs, and wall systems.

Partially Enclosed (High Internal Forces)

Definition
(ASCE 7-16 / FBC Reference)

A structure is considered partially enclosed when:

Aₒ>1.10×Aₒᵢ

Aₒᵢ /A₉ᵢ ≤ 0.20

Worked Example

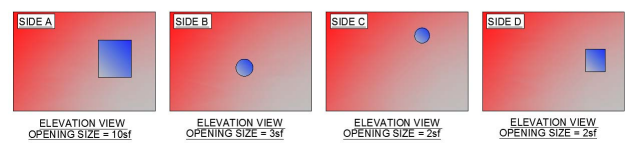

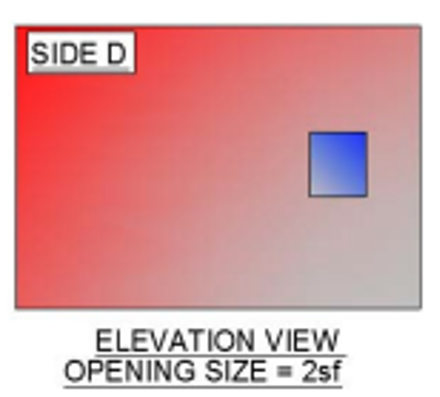

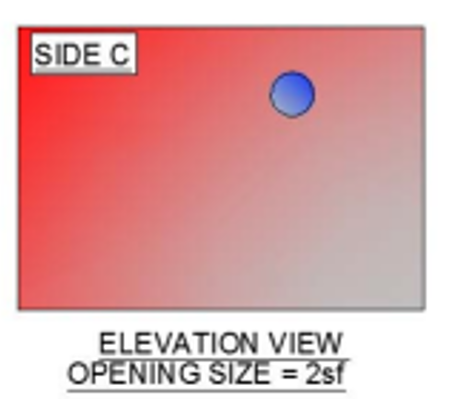

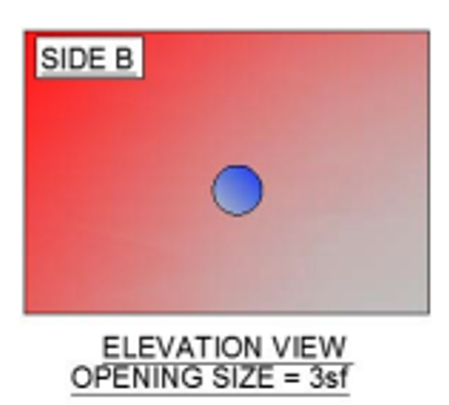

Consider a structure with five sides (four walls and a roof), having a gross area of 20 ft². The openings are shown in blue below:

concrete example of a partially enclosed structure roof all
concrete example of a partially enclosed structure roof

Conclusion: Both conditions are met → The structure is Partially Enclosed.

Condition 1

 (Side A)

Aₒᵢ  = 3+2+2+0 = 7 ft

1.10×Aₒᵢ = 7.7ft

Condition 2

A₉ᵢ ​= 4×20 ft+20 ft= 80 ft

Aₒᵢ /A₉ᵢ = 7/80 = 0.0875 ≤  0.20

ASCE 7-16 Guidance on Enclosure Definitions

According to ASCE 7-16 Section C26.2, the definitions of enclosed, open, and partially enclosed buildings are specifically intended to guide the selection of the correct internal pressure coefficient (GCpi).

All other structures that do not clearly meet one of these three definitions are classified as partially open by default. These include buildings with large openings on multiple walls—such as parking garages, where wind can pass freely through but the structure does not satisfy the strict “open” or “partially enclosed” criteria.

For such partially open structures, the internal pressure coefficient (GCpi) is typically ±0.18, and these pressures are applied to the solid portions of the walls and roof.

Importantly, if a building meets both the “open” and “partially enclosed” definitions, ASCE 7 requires it to be classified as “open.” This ensures that the more accurate (and typically less conservative) internal pressure assumptions are applied in design.
